Defect #8742

% done in parent task is incorrect

Added by Wendy Wong almost 2 years ago. Updated almost 2 years ago.

Status:NewStart date:2011-07-04
Priority:HighDue date:
Assignee:-% Done:

0%

Category:Issues planning
Target version:-
Affected version: Resolution:

Description

Hi,
I've created a parent task with 3 sub-tasks. All the sub-tasks have been closed with 100% but the % done in parent task is showing only 67% which is supposed to be 100%.

How can i rectify this problem as it affects my overall roadmap performance? Thanks


History

#1 Updated by Etienne Massip almost 2 years ago

Any plugins that could explain this ?

What is the estimated time of each subtask ?

#2 Updated by Etienne Massip almost 2 years ago

  • Category changed from Roadmap to Issues planning

#3 Updated by Wendy Wong almost 2 years ago

Etienne Massip wrote:

Any plugins that could explain this ?

What is the estimated time of each subtask ?

----------------------------------------------
~~ No plugins are being used

~~ No estimated time defined for each subtask, only due dates are defined

#4 Updated by Etienne Massip almost 2 years ago

What are the start and due dates of each task, please ?

#5 Updated by Wendy Wong almost 2 years ago

Etienne Massip wrote:

What are the start and due dates of each task, please ?

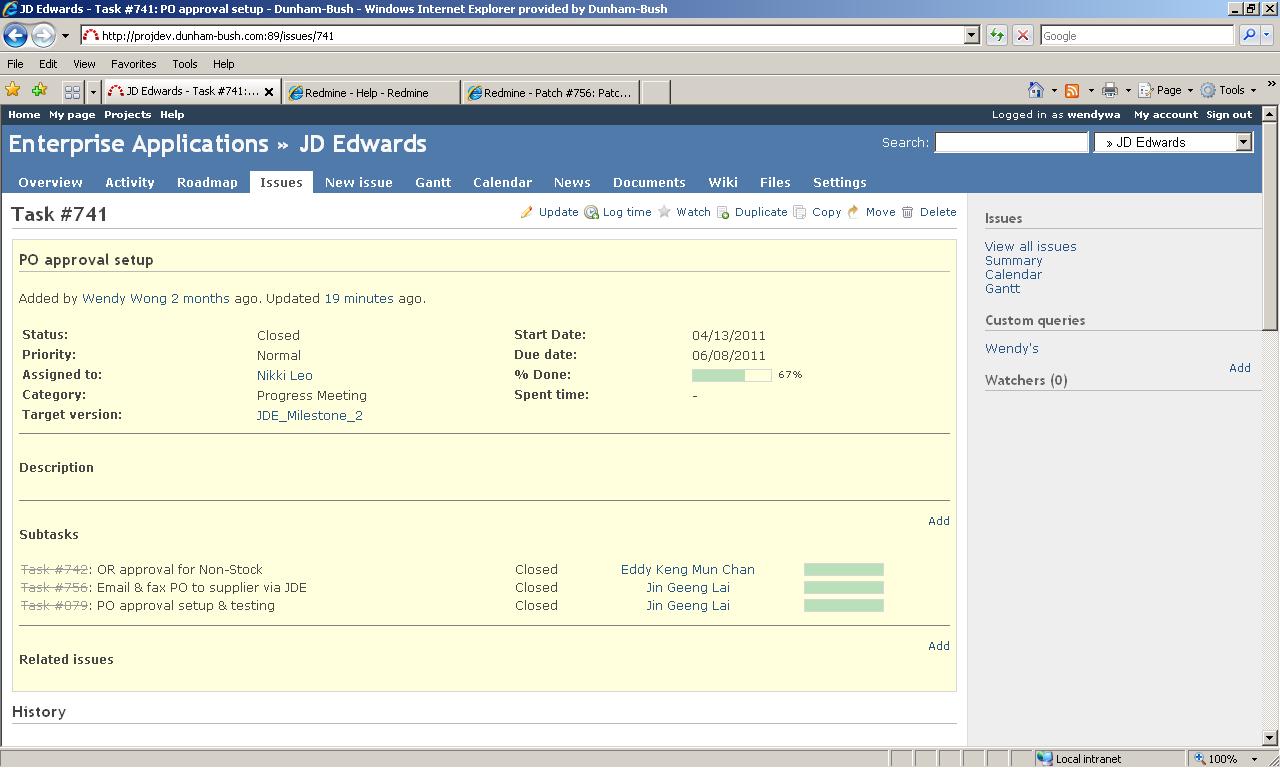

Parent task
-----------
13 Apr 2011 - 8 Jun 2011

Sub tasks
----------
1. 16 Apr 2011 - 6 May 2011
2. 15 Apr 2011 - 15 May 2011
3. 10 May 2011 - 8 June 2011

#6 Updated by Wendy Wong almost 2 years ago

Any updates?
