Project

General

Profile

Actions

Defect #43625

open

Duration is shortened by one day when adding a relation and the following issue starts on a non-working day

Added by Ken Nakaoka about 11 hours ago.

Status:
New
Priority:
Normal
Assignee:
-
Category:
Issues
Target version:
-
Start date:
Due date:
% Done:

0%

Estimated time:
Resolution:
Affected version:

Description

Overview

When adding a relation between issues,
if the start date of the following issue falls on a non-working day,
the issue’s Duration is shortened by one day.

Duration is expected to be calculated based on working days only.
However, when a relation is added and the following issue is rescheduled,
an unintended reduction of Duration occurs when the original start date is a non-working day.

Steps to reproduce

1. Configure the working calendar so that a specific date is marked as a non-working day
2. Create Issue A (preceding issue) with start date and due date set

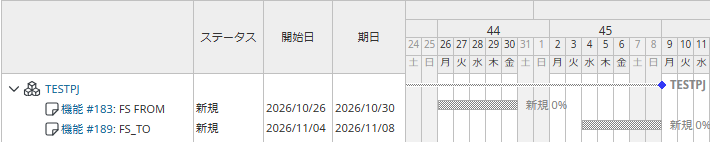

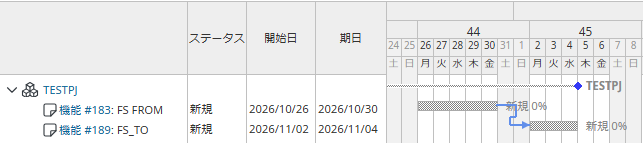

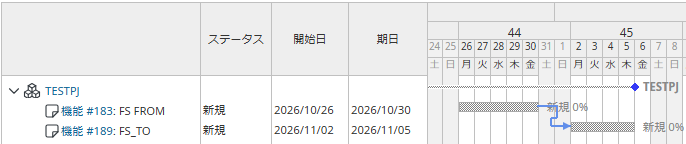

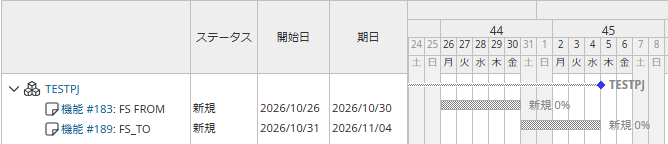

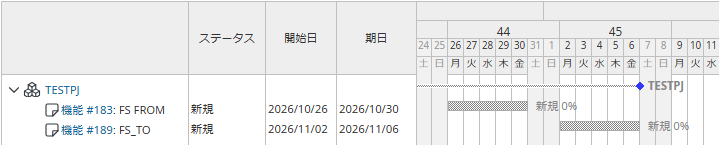

3. Create Issue B (following issue) with its start date set to a non-working day
4. Add a relation between Issue A and Issue B (e.g. precedes / follows)

Expected result

  • The Duration of the following issue remains correct, based on working days
  • The Duration is not automatically reduced when the start date is a non-working day

Actual result

  • After adding the relation, the Duration of the following issue is shortened by one day
  • This occurs when the original start date of the following issue is a non-working day

Environment (tested)

  • Redmine: 5.1.2
  • Ruby: 3.2.3
  • Database: PostgreSQL 16

Possible cause

In `Issue#reschedule_on`, the working duration is calculated before the start date is shifted to the next working day.
If the original start date is a non-working day, `working_duration` is already reduced by one day, and that value is then used to calculate the due date.

# app/models/issue.rb
def reschedule_on(date)
  wd = working_duration
  date = next_working_date(date)
  self.start_date = date
  self.due_date = add_working_days(date, wd)
end

As a result, the shortened `wd` is passed to `add_working_days`, and the Duration becomes shorter than intended.

Proposed improvement

If the difference (in days) between the original start date and the first working day is added to `wd` before rescheduling,
a start date on a non-working day can still be treated as one working day, and the original Duration can be preserved.

Example implementation:

# app/models/issue.rb
def reschedule_on(date)
  wd = working_duration
  if start_date
    carry = (next_working_date(start_date) - start_date).to_i
    wd += carry if carry > 0
  end
  date = next_working_date(date)
  self.start_date = date
  self.due_date = add_working_days(date, wd)
end

No data to display
