Actions
Patch #41312
closedUpdate MiniMagick to 5.0
Description
https://github.com/minimagick/minimagick/releases/tag/v5.0.0
https://github.com/minimagick/minimagick/releases/tag/v5.0.1
There are some incompatible changes in MiniMagick v5, but it seems to work fine. There was no difference in the output image, size, and processing time.
Below are the results of PNG images of Gantt charts output by MiniMagick v4 and v5, their sizes, and request processing times.

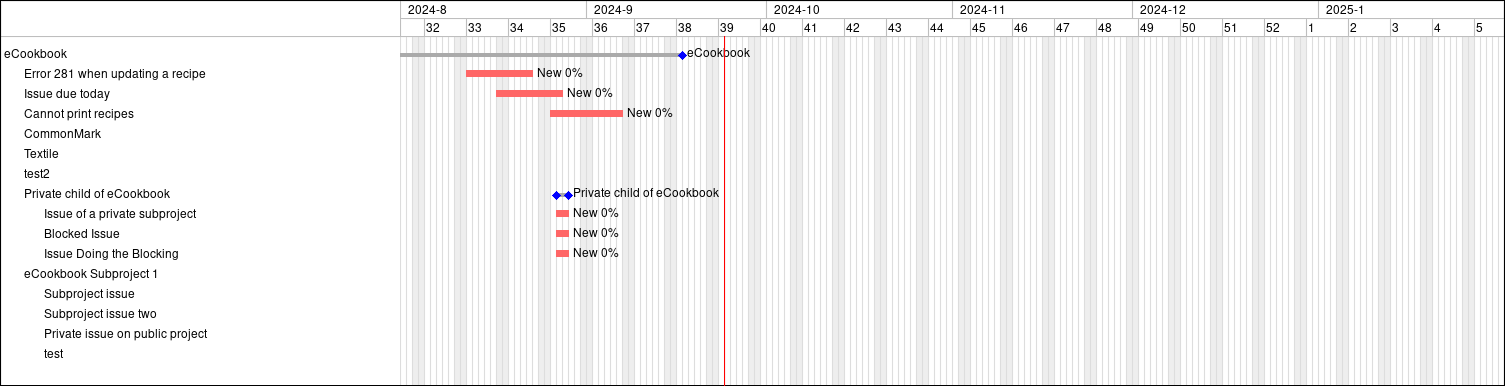

ImageMagick v6¶
$ convert --version Version: ImageMagick 6.9.11-60 Q16 x86_64 2021-01-25 https://imagemagick.org Copyright: (C) 1999-2021 ImageMagick Studio LLC
MiniMagick v4¶
Sent data ecookbook-gantt.png (2.9ms) Completed 200 OK in 2145ms (Views: 2.4ms | ActiveRecord: 14.0ms (43 queries, 3 cached) | GC: 35.5ms)
MiniMagick v5¶
Sent data ecookbook-gantt.png (2.0ms) Completed 200 OK in 2086ms (Views: 1.6ms | ActiveRecord: 14.5ms (43 queries, 3 cached) | GC: 13.2ms)

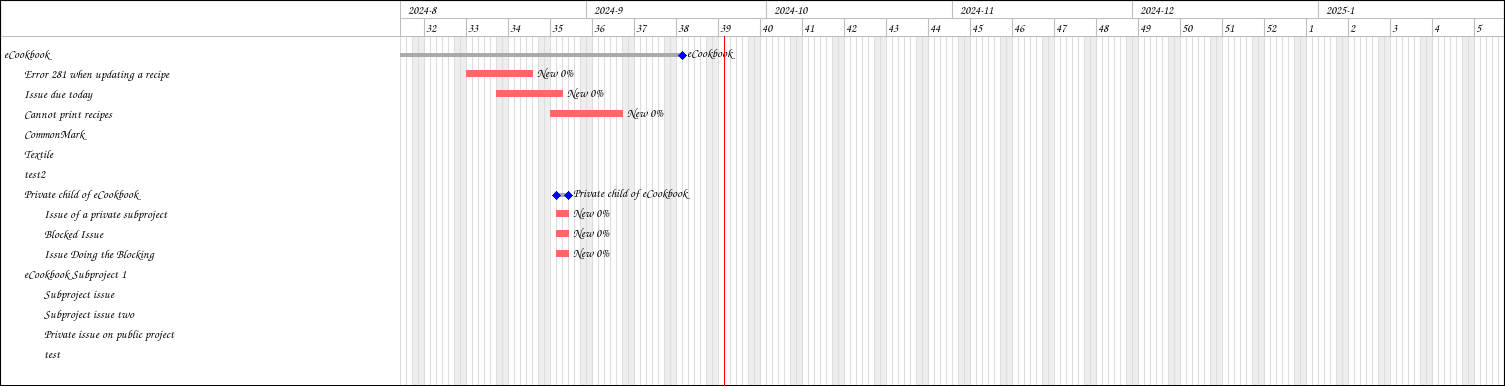

ImageMagick v7¶
$ magick --version Version: ImageMagick 7.1.1-38 Q16-HDRI x86_64 22398 https://imagemagick.org Copyright: (C) 1999 ImageMagick Studio LLC
MiniMagick v4¶
Sent data ecookbook-gantt.png (1.5ms) Completed 200 OK in 1514ms (Views: 1.1ms | ActiveRecord: 14.0ms (43 queries, 3 cached) | GC: 17.4ms)
MiniMagick v5¶
Sent data ecookbook-gantt.png (1.4ms) Completed 200 OK in 1048ms (Views: 1.0ms | ActiveRecord: 13.2ms (43 queries, 3 cached) | GC: 20.4ms)
Files
Related issues
Updated by Go MAEDA about 2 years ago
- Target version set to 6.0.0
Setting the target version to 6.0.0.
Updated by Go MAEDA about 2 years ago
- Subject changed from Update MiniMagick to v5.0.1 to Update MiniMagick to 5.0
- Status changed from New to Closed
- Assignee set to Go MAEDA
Committed the patch in r23099. Thank you for your contribution.
Updated by Go MAEDA about 2 years ago
- Related to Patch #40849: Update MiniMagick to 4.13 added
Updated by Go MAEDA over 1 year ago
- Related to Defect #42558: JPEG images are not shown in exported PDF files added
Actions
