Actions
Defect #6763
closedNew gantt charts: subject displayed twice on issues
Defect #6763:
New gantt charts: subject displayed twice on issues
Resolution:
Fixed
Affected version:
Description

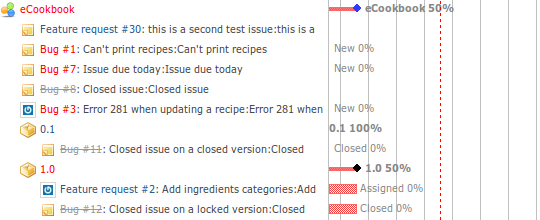

See screenshot:

Probably due to the fact that link_to_issue already displays the subject of the issue by default. So lines 539 and 540 of lib/redmine/helpers/gantt.rb are redundant. Eric I let you confirm.
Files
Updated by Jean-Philippe Lang about 16 years ago
- Status changed from New to Closed
- Assignee deleted (
Eric Davis) - Resolution set to Fixed
Fixed in r4392.
Actions
