Project

General

Profile

Actions

Defect #5149

closed

The roadmap progessbar is strange

Added by Jérémie Augustin about 15 years ago. Updated about 15 years ago.

Status:
Closed
Priority:
Normal
Assignee:
-
Category:
Roadmap
Target version:
-
Start date:
2010-03-22
Due date:
% Done:

0%

Estimated time:
Resolution:
Invalid
Affected version:

Description

My progessbar on some project seams to be wrong

Example:

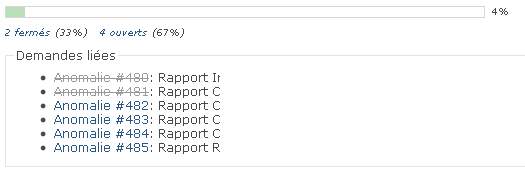

I have 6 tickets 2 closed (33%) and 4 opened (67%) and the overall progress is 4% (screen attached)

second example

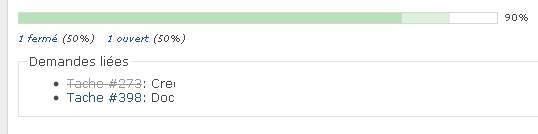

2 tickets : 1 closed 1 opened (the opened ticket is 50% finished) the overall progress is 90% I think it should be 75% (screen attached)


Files

bug_redmine.jpg (12.1 KB) bug_redmine.jpg bug progressbar Jérémie Augustin, 2010-03-22 15:32
bug_redmine_2.jpg (7.27 KB) bug_redmine_2.jpg Jérémie Augustin, 2010-03-22 15:40
Actions #1

Updated by Jérémie Augustin about 15 years ago

The bug didn't apply to all projects/versions only some of them

second screenshot attached

Actions #2

Updated by Felix Schäfer about 15 years ago

I think this progress bar takes into account the "% done" field to make this calculation, i.e. if you have one ticket at 100% and the other at 50%, you will get a total of 75% done in the progress bar, though none of them might be closed.

Actions #3

Updated by Jérémie Augustin about 15 years ago

I understand the feature the same way as you that's why I submit the bug

First example it should display 33% (2 ticket closed with 100% and 4 opened with 0%) but the displayed value is 4%
I add more tickets to my version and progessbar continue to have wrong value:
2 ticket closed with 100% and 5 tickets opened with 0% and 1 opened with 50%
the result is 7% (3% green 4% light green) it should be 31% (25% green + 6% light green)

in the second example the progressbar is 90% (80% green + 10% light green) but it should be 75% (50% green + 25% light green)

Is the calcul of the progressbar done every time or is it store somewhere (and could be corrupted)

Actions #4

Updated by Jérémie Augustin about 15 years ago

the progressbar seems to be based on "estimated time" and not "% done" is it normal?

Actions #5

Updated by Mischa The Evil about 15 years ago

Jérémie Augustin wrote:

the progressbar seems to be based on "estimated time" and not "% done" is it normal?

This seems to be a faulty documented feature. The current wiki states:

[...] a progress bar which indicates overall active/done/closed-ratio based on the %-done and statuses of the issues targeted to [...]

This information is wrong starting from Redmine 0.9.0 which includes r2349 for issue #2182. For that issue and for #2139 Jean-Philippe Lang changed the function as explained by him at #2182#note-6:

It uses estimated time to weight each issue. Issues with no estimated time are weighted with the average estimated time.

If no issues are estimated, they receive the same weight, so we fall back in the current calculation. For this reason, I think we don't have to make this new calculation method an option.

Hope this helps and please feel free to update the wiki accordingly to reflect the change in Redmine behaviour... :)

Kind regards,

Mischa.

Actions #6

Updated by Jean-Philippe Lang about 15 years ago

  • Status changed from New to Closed
  • Resolution set to Invalid

Indeed. I made a slight update to the documentation.
