Project

General

Profile

Actions

Defect #6714

closed

Gant visualization issue

Defect #6714: Gant visualization issue

Added by Jose Javier Sianes Ruiz about 16 years ago. Updated almost 16 years ago.

Status:
Closed
Priority:
Normal
Assignee:
-
Category:
Gantt
Target version:
-
Resolution:
Invalid
Affected version:

Description

We have an estrange Gant visualization issue. In a project when we request to show gant the visualizacion seems to be correct when only open issues are displayed. But when we select to show all issue, issues with subtask closed and opens apears twice (look at issue number 1335), once showing only closed subtask and other with closed and open subtasks. Could be a bug in gant representation module of Redmine? We are using 1.0.1 stable version of Redmine.


Files

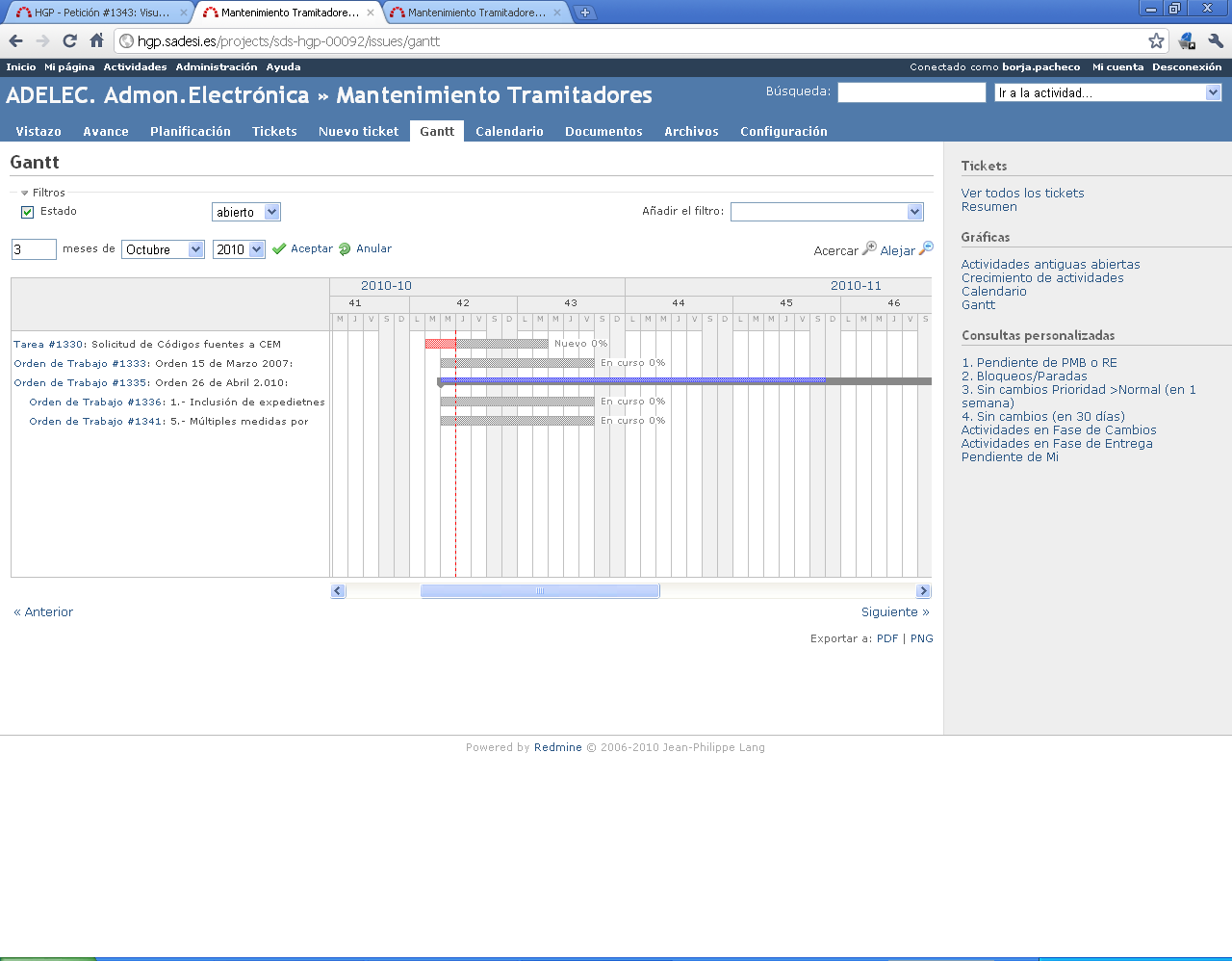

gantt-opens.PNG (75.8 KB) gantt-opens.PNG Gant showing open issues Jose Javier Sianes Ruiz, 2010-10-20 18:30

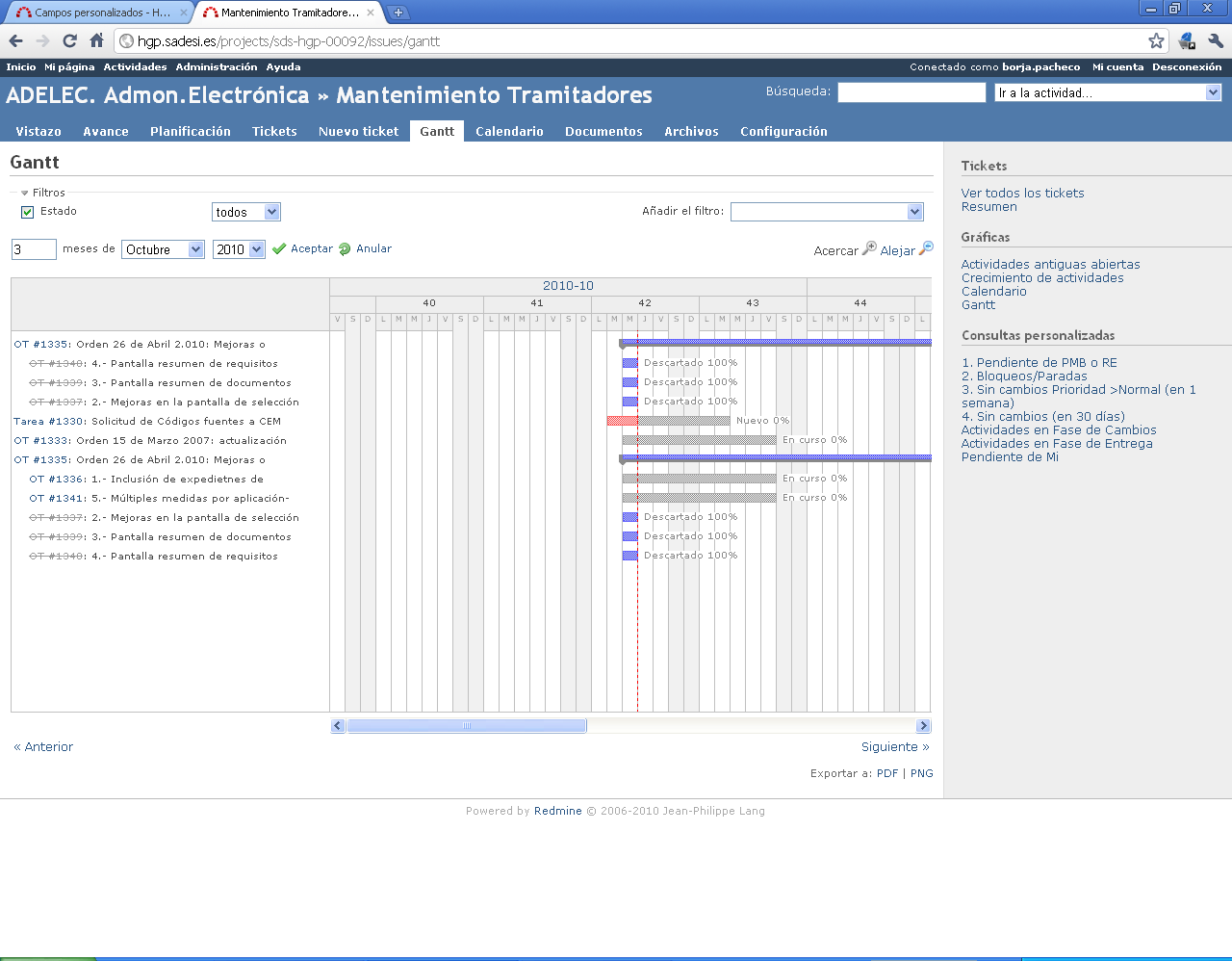

gantt-all.PNG (89.5 KB) gantt-all.PNG Gant showing open and closed issues Jose Javier Sianes Ruiz, 2010-10-20 18:30

Updated by Jean-Baptiste Barth about 16 years ago Actions #1

Gantt charts has been completely rewritten for Redmine 1.1.0, which will be released in the end of 2010. It seems parent task to subtasks relations are not displayed anymore in the new implementation, and I cannot reproduce the bug with it.

Other contributors: any idea of what we should do here ?

Updated by Eric Davis about 16 years ago Actions #2

Jean-Baptiste Barth wrote:

It seems parent task to subtasks relations are not displayed anymore in the new implementation, and I cannot reproduce the bug with it.

Parent/child issues are displayed in the new implementation.

Since 1.1 is only a few months away and since the Gantt was completely rewritten, I think this should be closed as won't fix. Any work put into 1.0.x for Gantts will be thrown away.

Updated by Jean-Baptiste Barth about 16 years ago Actions #3

Eric Davis wrote:

Parent/child issues are displayed in the new implementation.

Hm, not on my tests 5 mins ago :( I'll try to find why and add an issue if needed.

Updated by Jose Javier Sianes Ruiz about 16 years ago Actions #4

So, do you recommend me to upgrade version 1.1.0 to solve the problem?

Updated by Jose Javier Sianes Ruiz about 16 years ago Actions #5

  • Status changed from New to Resolved

Solved in #6763

Updated by Mischa The Evil almost 16 years ago Actions #6

  • Status changed from Resolved to Closed
  • Resolution set to Invalid

Jose Javier Sianes Ruiz wrote:

Solved in #6763

Thanks for the feedback. Though I doubt that it was the solution for #6763 which fixed your issue.
