Project

General

Profile

Actions

Feature #26409

closed

Show assignee on gantt

Added by Go MAEDA over 9 years ago. Updated over 7 years ago.

Status:
Closed
Priority:
Normal
Assignee:
-
Category:
Gantt
Target version:
-
Resolution:
Duplicate

Description

Needless to say, assignee is important information to manage projects. It would be great if assignee is displayed on gantt.

I have found some similar requests on the forum:


Files

show_assignee_on_gantt.patch (14 KB) show_assignee_on_gantt.patch Mizuki ISHIKAWA, 2017-07-28 03:12

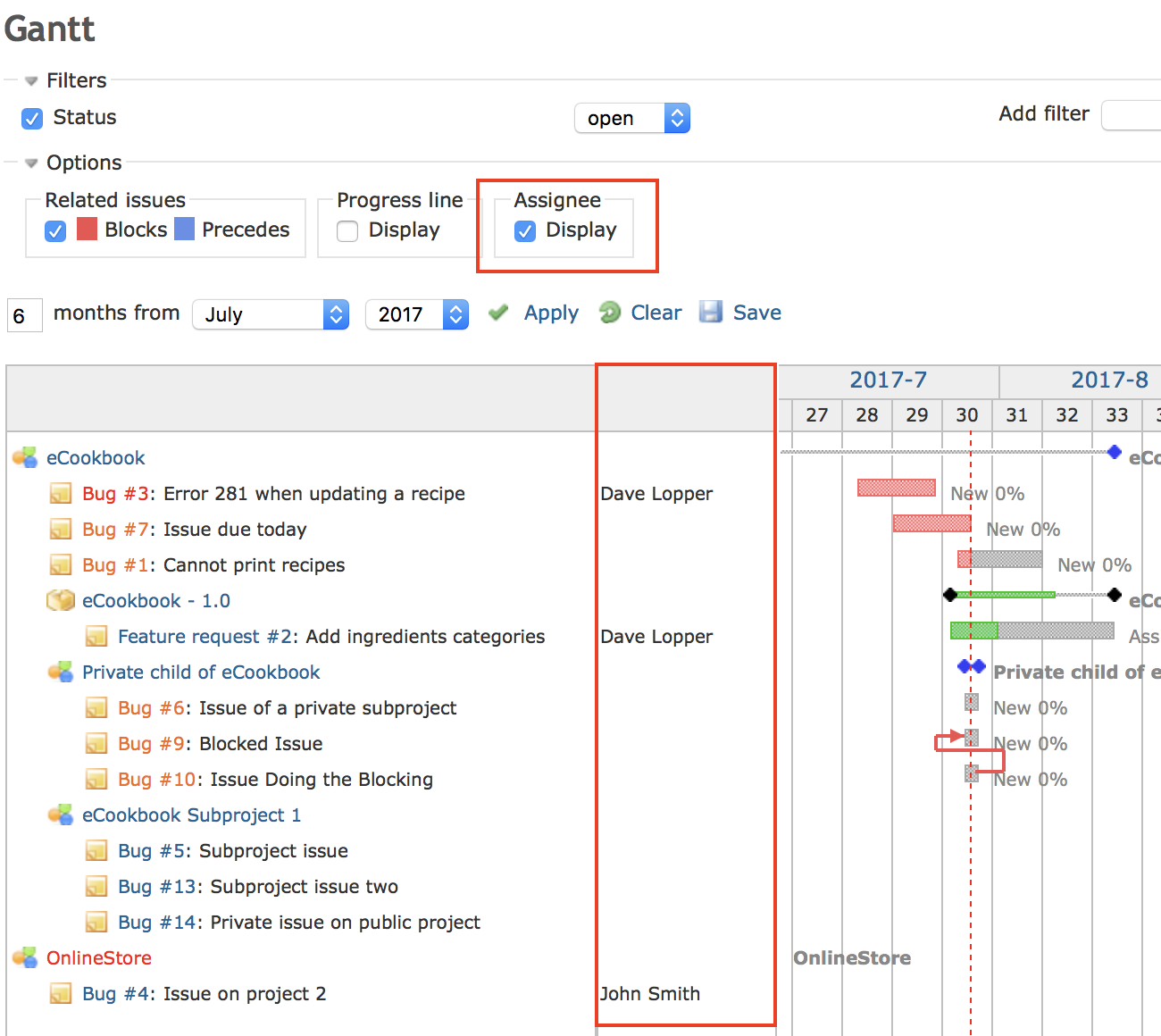

assignee_on_gantt.png (248 KB) assignee_on_gantt.png Mizuki ISHIKAWA, 2017-07-28 03:12
show_assignee_on_gantt.patch_v2.patch (14.2 KB) show_assignee_on_gantt.patch_v2.patch Mizuki ISHIKAWA, 2017-08-17 10:27
show_assignee_on_gantt_v3.patch (14.4 KB) show_assignee_on_gantt_v3.patch Mizuki ISHIKAWA, 2017-11-27 03:25

Related issues

Related to Redmine - Feature #27672: Show selected columns in gantt chartClosedGo MAEDAActions
Blocked by Redmine - Feature #20481: Gantt: right and left resizable panelClosedGo MAEDAActions
Actions #1

Updated by Yuuki NARA over 9 years ago

+1
I think so, too

Actions #2

Updated by Mizuki ISHIKAWA about 9 years ago

I wrote a patch to implement this feature.
You can switch the display like Progress line.

This patch is made on the premise that a patch of Feature #20481 (Gantt: left and right resizable panels) is applied.
Before applying this patch, apply the patch of Feature #20481 .

Actions #3

Updated by Go MAEDA about 9 years ago

  • Blocked by Feature #20481: Gantt: right and left resizable panel added
Actions #4

Updated by Go MAEDA about 9 years ago

  • Target version set to 4.1.0

I think this is a must-have feature for most gantt users. Setting target version to 4.1.0.

Actions #5

Updated by Marius BĂLTEANU about 9 years ago

I've tested the patch and I've two observations:
1. the patch doesn't apply cleanly on the current trunk (r16948).
2. it'll be nice to have also gravatar shown for the assignee.

Actions #6

Updated by Go MAEDA about 9 years ago

Marius BALTEANU wrote:

1. the patch doesn't apply cleanly on the current trunk (r16948).

The patch depends on another patch #20481. Could you try again after applying it?

2. it'll be nice to have also gravatar shown for the assignee.

I agree with you. Gravatar icon should be shown for consistency.

Actions #7

Updated by Marius BĂLTEANU about 9 years ago

Go MAEDA wrote:

Marius BALTEANU wrote:

1. the patch doesn't apply cleanly on the current trunk (r16948).

The patch depends on another patch #20481. Could you try again after applying it?

Sorry for the mistake, it seems that my local repository didn't have the latest changes from the trunk. Now the second patch applies cleanly.

Actions #8

Updated by Mizuki ISHIKAWA about 9 years ago

Marius BALTEANU wrote:

…
2. it'll be nice to have also gravatar shown for the assignee.

Thank you for your advice.

I changed patch as follows:

--- a/lib/redmine/helpers/gantt.rb
+++ b/lib/redmine/helpers/gantt.rb
@@ -336,7 +336,10 @@ module Redmine
       def assigned_to_name(issue, options)
         if issue.is_a?(Issue) && options[:format] == :html && issue.assigned_to.present?
           style = "position: absolute;top: #{options[:top]}px;"
-          assigned_to_name = view.content_tag(:div, view.content_tag(:span, issue.try(:assigned_to).try(:name)), :style => style, :class => 'issue-assigned-name')
+          content = view.avatar(issue.assigned_to,
+                                 :class => 'gravatar icon-gravatar',
+                                 :size => 10) + view.link_to_user(issue.assigned_to)
+          assigned_to_name = view.content_tag(:div, content.html_safe, :style => style, :class => 'issue-assigned-name')
           @assigned_to_names << assigned_to_name
           assigned_to_name
         end

Actions #9

Updated by Mizuki ISHIKAWA almost 9 years ago

I fixed the patch.

  • Compatible the latest trunk.
  • Add styles to gravatar like #26410
Actions #10

Updated by Mischa The Evil almost 9 years ago

I don't want to ruin anyone's party, but I'd like to drop some thoughts (concerns) I have about this feature and the proposed, patched implementation:
  • what's the actual significance of the assignee over other attributes (priority for example, which is in my opinion evenly important as assignee in gantt context)? From this follows that depending on the use, one might have need for every single attribute and/or even custom values, which simply cannot all be implemented
  • for the current need to see an issue's assignee, we already have it in the pop-up by hovering over the item bar...
  • I think that the use of the option checkboxes like in the patch feels weird as the other two checkboxes switch (JS) functionality (lines) onto the gantt chart bars, while this checkbox switches functionality regarding gantt chart bar attribute columns

I'd like to have some more feedback on this.

Actions #11

Updated by Mizuki ISHIKAWA almost 9 years ago

Mischa The Evil wrote:

  • what's the actual significance of the assignee over other attributes (priority for example, which is in my opinion evenly important as assignee in gantt context)? From this follows that depending on the use, one might have need for every single attribute and/or even custom values, which simply cannot all be implemented

Thank you for your feedback.
As you say, there are other necessary information besides the Assignee.
I think that this issue can be closed if the #27672 feature is realized.
What do you think?

I am writing a patch that realizes the feature of #27672 based on the patch of this issue now.

Actions #12

Updated by Alessandro Zucchi almost 9 years ago

Move first in 4.0 ???
Gantt without assignee is no a gantt
Regards
Alessandro

Actions #13

Updated by Mischa The Evil over 8 years ago

  • Related to Feature #27672: Show selected columns in gantt chart added
Actions #14

Updated by Go MAEDA over 7 years ago

  • Target version deleted (4.1.0)
Actions #15

Updated by Go MAEDA over 7 years ago

  • Status changed from New to Closed
  • Resolution set to Duplicate

Closing this issue because #27672 includes this feature. I hope to commit that patch soon.

Actions

Also available in: Atom PDF
